          Documentation and execution


          Once the line is confirmed piggable the execution phase


          requires a comprehensive range of documents, which could


          include:


          )


          )


          Health, Safety and Environment (HSE) policies.


          )


          )


          HAZID review documents.


          )


          )


          Material safety data sheets.


          )


          )


          Project, inspection vendor and waste disposal method


          statements.


          )


          )


          Site pigging procedures.


          )


          )


          Lifting plans.


          )


          )


          Pig run contingency planning.


          )


          )


          Inspection vendor equipment lists.


          )


          )


          Reference drawings.


          )


          )


          Project plans and relevant project documents.


          )


          )


          Contact lists.


          )


          )


          Post run decontamination procedure (NORMS, mercury,


          benzene etc. can all contaminate pipeline pigs).


          Prior to mobilisation, a factory acceptance test (FAT)


          should be performed with the ILI vendor to identify any


          issues prior to incurring costly mobilisation charges. On


          a recent FAT visit I captured the inspection tool vendor


          preparing to mobilise a lower specification tool than that


          specified, something an inexperienced operator might have


          missed.


          So now you have got your people in-country, all the


          required training is complete, the inspection tool is at the pig


          trap and the technician informs you there is an issue with the


          tool and it cannot therefore be run.


          OK, this may be an exceptional circumstance, but it


          does happen. Reasons could include flat batteries, faulty


          electronics, damage which occurred during transportation


          and a host of other things. Sometimes these issues can be


          resolved onsite, but what if the length of time to fix the


          problem means you have missed the batch of product that


          you were going to use to propel the tool?


          Now assuming the pig has been run, then everyone


          will be eager to know the outcome of the inspection with


          the onsite technician under pressure to ‘tell me where


          there’s a defect?’ from the often expectant client. Now,


          the most you can expect from the field technicians onsite


          is confirmation that the tool has or has not functioned


          correctly, and whether it has or has not collected a full


          data set.


          Issues with incomplete data can be attributed to:


          )


          )


          Debris in the pipeline – who was responsible for cleaning


          the pipeline?


          )


          )


          Damage to the inspection tool – a partially closed valve,


          velocity excursions, wear and tear, etc. could all be


          contributors.


          )


          )


          Product issues, flow, velocity, pressure, temperature etc.


          )


          )


          Onboard electronics issues.


          )


          )


          Sensor issues causing data loss.


          This list goes on. As inspection tools are in high demand,


          some negotiation will often take place with the inspection


          tool vendor, trying to persuade you to accept the degraded


          inspection data. The implications of any decision to accept


          data of a degraded quality need to be fully understood


          along with the impact this will have on any future integrity


          assessments planned.


          With a large percentage of the world’s pipelines still


          considered unpiggable for current inspection technologies,


          a well-executed piggability study along with a well planned


          and executed inspection programme will help fill in the


          blanks for you and may just keep you one step ahead of the


          regulator.


          Figure 6.


          Pyrophoric dust on fire inside the pig trap.

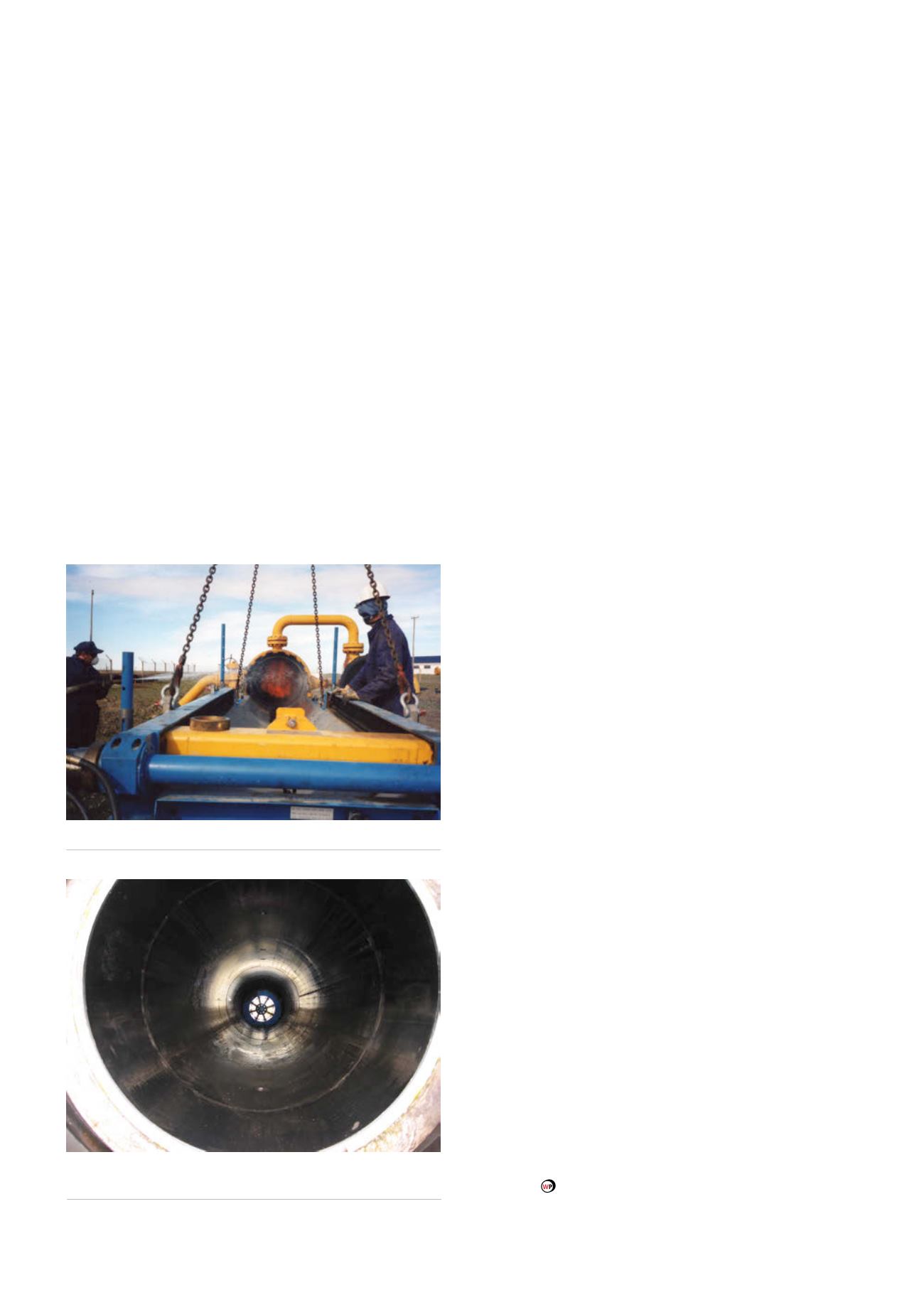

          Figure 5.


          The end goal, a clean pipeline and a successful


          inspection.
